ESPNRice bests Boone's belief by slugging homers 40, 41ESPN DeportesPortugal y CR7 debutan en la Nations LeagueBollywood HungamaSajid Nadiadwala’s Nadiadwala Grandson seals 11-month Andheri office space deal; pays Rs. 55 lakhs upfrontDaily MaverickLedgers of femicide: Why SA men think they’re the exceptionDigital SpyEastEnders confirms big Ash Panesar twist - here's what she's hidingAnime News NetworkCrunchyroll Screens Dive in Wonderland Film on November 16 in U.S. as Part of Anime Nights ProgramDeadlineApple TV Comedy ‘Protective Custody’ Rounds Out Cast With Five More AdditionsBillboardHere Are the Performers & Presenters for the 2026 VMAsPinkvillaAvengers Endgame Encore India Final Advance Booking: Marvel film sells 85,000 tickets in National Chains, eyes good startSportstarPortugal vs Wales LIVE SCORE - Cristiano Ronaldo almost scores in UEFA Nations League; POR vs WAL updatesWirtualna PolskaDwulatek wypił chemię budowlaną. Interweniował LPRCollider11 Years Later, This Forgotten 8-Part Fantasy Feels Like It Was Made To Be Binged
The Daily Newsstand · Free, Always
Thursday, September 24, 2026

Launch of UK’s ‘largest AI supercomputer’ delayed by power supply problems

Translate

A huge datacentre project hailed by the UK government will miss its launch date next year and could be delayed into the mid-2030s.

The site in Loughton, Essex, was described as the country’s largest AI supercomputer when it was announced in 2025, but power supply problems mean it now faces a lengthy wait before coming online.

Doubts had already emerged about the scheme after the Guardian revealed in March that the planned location was still an operational scaffolding yard.

Now there are further concerns about the project due to its inability to obtain enough power before its planned 2027 debut. The Loughton supercomputer is being built by Nscale, a UK-based startup seeking a $35bn (£26bn) flotation this year.

UK Power Networks (UKPN), the company that will connect the site to the local power grid, has reportedly told Nscale the grid will not be able to supply sufficient power to the datacentre until the early to mid-2030s.

The power delay was first reported by Morning Intelligence, an AI industry newsletter.

Nscale said it was “committed to the project” but the failure tofind a quick fix to the power supply issue underlines how much energy has become a hinderance to datacentre development. The scaffolding yard site has now been cleared by Nscale, however. The company is also investigating whether it can generate power on-site and whether it can speed up the connection process.

Keir Starmer’s government cited the Loughton project when announcing the UK’s AI strategy in 2025, describing the site as the “largest UK sovereign AI datacentre”. Datacentres are the central nervous system of AI technology such as chatbots.

Scaffolding business.

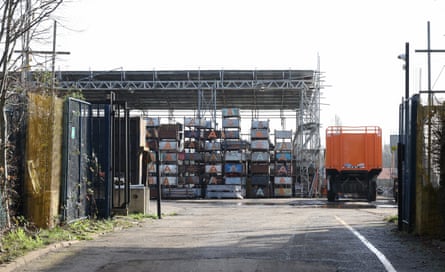

The scaffolding company, which was operating on the site. Photograph: Martin Godwin/The Guardian

Ofgem, the energy industry regulator, has warned of a logjam in applications for electricity connections. In June, it revealed there were 315 datacentres queueing to connect to the National Grid, representing 73GW of demand – compared with the peak energy demand for the entire country of 45GW.

The Loughton site is seeking up to 90MW of capacity, equivalent to the energy consumption of about 315,000 homes.

UKPN said it could not comment on an individual project. Schemes with large energy demand also require work to be done at a National Grid level, in order to ensure that energy demands can be met properly.

“In general, many datacentres, whilst they will connect to our distribution network, are awaiting works on the wider national electricity transmission network before they can begin operation,” said a UKPN spokesperson.

National Grid said: “We’re continuing to work closely with NESO [the government-owned National Energy System Operator], distribution network operators and customers to identify opportunities to accelerate connections where possible and support economic growth.”

View the original on The Guardian →
